How does APFC actually enable interconnections?

June 6, 2024

Advanced power flow control can support generator interconnection when a flow-driven transmission constraint is limiting the connection. By shifting power onto paths with available capacity, it can be evaluated alongside other network upgrades. It does not replace interconnection studies, agreements, or required reliability approvals.

In this article, Ted Bloch-Rubin explains the role of flexible transmission technologies and shares project examples. For the regulatory context, see FERC’s interconnection-rule explainer; the applicable tariff and approved implementation determine the process for each project.

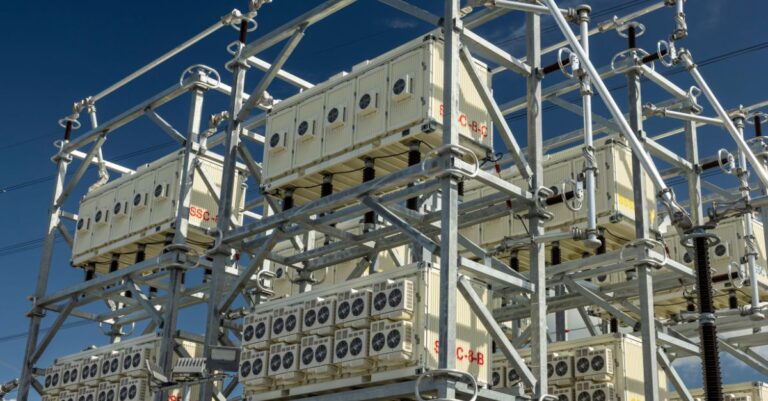

SmartValve units on a substation structure

In my earlier article, I discussed Order 2023 and the potential role of flexible transmission technologies in generator interconnection. FERC’s Order 1920 explainer, including subsequent rehearing orders, describes consideration of advanced power flow control and other technologies in regional transmission planning. These are evaluation requirements; they do not mandate selection of SmartValve or guarantee a faster connection. Here, I focus on how APFC can address particular network constraints.

I’ll focus on APFC for this article, but it’s worth noting that other ATTs may help interconnect renewables in different ways. For example, advanced conductors can be used to replace aging infrastructure with state-of-the-art conductors that can carry more electricity along the same circuit.

Firstly, APFC uses power electronics to change a circuit’s effective reactance and influence how power is shared across a transmission network. Where studies identify useful alternative paths with available capacity, this can relieve a binding flow constraint. Any stability benefit and its control settings must be evaluated for the specific application.

SmartValve’s modular design allows installations to be expanded or modules to be relocated as network needs change, subject to engineering and site requirements. Supported voltage and current ratings, protection, controls, outage access, and delivery requirements must be checked for the intended application. Modularity does not remove these requirements or establish a universal delivery schedule.

Utilities should use validated APFC models appropriate to their planning tools and study objectives, and confirm model versions and control assumptions with their transmission technology provider.

These attributes make APFC an option to assess for increasing usable transmission capability where power-flow constraints are limiting new generation. The resulting capacity, reliability performance, and interconnection schedule remain specific to the network and project.

The following projects illustrate different uses of SmartValve to address transmission constraints relevant to moving power across existing networks:

In New York State, Central Hudson reports installing 15 SmartValves at Hurley Avenue, making 185 MW of additional grid capacity available. Its project page identifies estimated savings of $10 million compared with other options and a smaller footprint. These are the utility’s project-specific statements, not a generic cost or capacity guarantee. Read the Smart Wires case study for additional project context.

Across the Atlantic, National Grid reported in May 2024 SmartValve installations at three substations across five circuits, with more than 2 GW of north–south power-flow capacity being unlocked. Its announcement estimated about £390 million in savings over seven years from reduced constraint costs and avoided new infrastructure expenditure. This is a forecast with that scope and currency, not verified savings already realized or a result that can be assumed for another network.

In Australia, Transgrid’s April 2021 VNI Minor announcement describes power flow controllers at Stockdill and a planned 170 MW transfer increase for the upgrade project under relevant network conditions. The technology controls flows between circuits as part of that project. This source supports the application and planned transfer benefit; it is not evidence of a universal device capacity or realized financial savings. See the Smart Wires project overview for further context.

APFC belongs to the grid-enhancing technologies category. These technologies can improve use of existing infrastructure in suitable applications and may complement reconductoring, new transmission, and other network investments. Cost and delivery advantages require a comparison for the specific need.

If you missed part 1 of this article on Order 2023, you can read it here.



Interconnection planning questions

How can APFC help a new generator connect?

APFC can address a flow-driven constraint by shifting power from a limiting circuit to another useful path with available capacity. If studies show that this resolves the required network need, it can be evaluated as part of the interconnection upgrade package. The Central Hudson case study provides a project example.

Can APFC remove every interconnection delay?

No. Queue administration, affected-system studies, agreements, financing, equipment procurement, permits, and other network upgrades can still determine the schedule. Additional transmission headroom does not itself grant permission to connect or establish a commercial-operation date.

Does FERC Order 2023 require a utility to install APFC?

No. FERC’s interconnection-rule explainer describes evaluation of alternative transmission technologies, including advanced power flow control, during cluster studies. Evaluation is not an instruction to select a particular technology or supplier. The applicable tariff and approved implementation govern the specific process.

Are generator interconnection and large-load connections the same?

No. One connects a source of generation; the other adds electricity demand. They may be affected by some of the same transmission constraints, but their studies and service arrangements differ. Berkeley Lab’s Queued Up research covers generation and storage requests, not a national data center queue.

What should be compared before selecting APFC?

Compare the binding constraints, normal and contingency cases, controllable transfer capability, site and outage requirements, protection and controls integration, cost, and the effect of future network changes. The study should also show where reconductoring, substation work, or new transmission remains necessary.
